Generate Gantt Chart in Python

A step by step tutorial on how to create a simple Gantt Chart using matplotlib in python

Introduction: What is Gantt Chart

A Gantt chart, the most common method used in project management to visualize project schedule and status. A Gantt chart is a type of bar chart showing activities (tasks or events) displayed against time. The chart is named after its inventor, Henry Gantt, who designed such a chart around the early twentieth century.

In this article I will explain how to create a Gantt chart in python using matplotlib library.

Import Libraries

First step in programing a Gantt Chart is importing the required libraries: 1. Pandas : Reading data and data analytics 2. Matplotlib : Data visualization 3. Datetime : Date manipulation

import pandas as pd
import matplotlib.pyplot as plt
import datetime as dt

Reading the data

The inputs for preparing a basic Gantt chart are the start date and the end date of each task. I have a simple schedule in the csv file simple_schedule.csv which contains details of four tasks which constitute the project. The data can be accessed by using pandas package.

df=pd.read_csv('simple_schedule.csv')
df
Image by author

Data Pre-processing

When reading date from a data source, usually pandas considers it to be of object/string datatype. The start and end dates have to be converted into pandas datetime format.

df.start=pd.to_datetime(df.start)
df.end=pd.to_datetime(df.end)
df['duration']=df.end-df.start
df
Image by author

Note that the duration is in datetime.timedelta format. This has to be converted to number of days. If the start and end date of a job is the same, time delta will be zero. However, the duration of the task will be 1 day. The same is true for every task, hence the duration has to be increased by one.

Ordering the tasks in ascending order of dates is a best practice in generating a Gantt chart, it renders the chart easy to comprehend. In this example, the tasks are ordered in ascending order of start date and hence this step may be skipped. However, I am including this step so that the chart can be generalized.

#convert duration to number and add one
df.duration=df.duration.apply(lambda x: x.days+1)
#sort in ascending order of start date
df=df.sort_values(by='start', ascending=True)
df
Image by author

Creating Gantt Chart

Now we have all the details necessary for generating a Gantt chart. We will create the chart by plotting horizontal bar chart using barh function of pyplot. Tasks will be specified on the y-axis. Duration of the task will determine its width. The start date determine the start of the bar which in case of barh chart is left.

plt.barh(y=df.Task, left=df.start, width=df.duration)
plt.show()
Image by author

This above is the output of our previous command! We can derive information about the tasks just by looking at the chart. We can observe the following problems with the chart: 1. The y-axis need to be inverted. 2. The x-axis labels does not convey any meaning

Solving the problem 1. is simple, the axis can be inverted using invert_yaxis function.

Create Meaningful x-axis

The x axis must convey the project duration and include dates as x tick labels.

For this purpose we have to first create the project level variables for start and end dates of the project and project duration.

p_start=df.start.min()
p_end=df.end.max()
p_duration=(p_end-p_start).days+1
print('project duration :', p_duration)
print('project start date :', p_start)
print('project end date :', p_end)
Output:
project duration : 12
project start date : 2021-06-14 00:00:00
project end date : 2021-06-25 00:00:00

The number of x-ticks should be 1 more than the project duration. The x-tick labels should be equal to the number of x-ticks, starting with the project start date. Note that the dates are in datetime format which includes the timestamp(refer the previous output). However, for labeling purpose, we require date in short format, which can be achieved by using strftime function. I have formatted the dates in ‘DD-Mon’ format using ‘%d-%b’ argument. Since this is a small 12 days project, year is omitted.

#xticks
x_ticks=[i for i in range(p_duration+1)]
#xtick labels starts with project start date |formatted
x_labels=[(p_start+dt.timedelta(days=i)).strftime('%d-%b')
          for i in x_ticks]
#print xticks and labels
print('x-ticks: ', x_ticks)
print('x-tick labels :', x_labels)
Output:
x-ticks:  [0, 1, 2, 3, 4, 5, 6, 7, 8, 9, 10, 11, 12]
x-tick labels : ['14-Jun', '15-Jun', '16-Jun', '17-Jun', '18-Jun', '19-Jun', '20-Jun', '21-Jun', '22-Jun', '23-Jun', '24-Jun', '25-Jun', '26-Jun']

Add relative dates

The start date in the DataFrame is the absolute date in which the task starts. We have to convert the absolute date to relative date so that it is in alignment with the x-ticks. The project start date corresponds to 0. The relative dates can be added as a new column-rel_start by using the following code.

df['rel_start']=df.start.apply(lambda x: (x-p_start).days)
df
Image by author

Final Gantt Chart

Putting everything together, the final Gantt chart can be created by the following code.

plt.figure(figsize=(8,4))
#plot barh chart
plt.barh(y=df.Task, left=df.rel_start, width=df.duration)
#Invert y axis
plt.gca().invert_yaxis()
#customize x-ticks
plt.xticks(ticks=x_ticks, labels=x_labels)
#Title
plt.title('A simple Gantt Chart')
#rotate x-ticks
plt.xticks(rotation=60)
#add grid lines
plt.grid(axis='x', alpha=0.5)
#save fig
plt.savefig('simple_gantt.png')
plt.show()

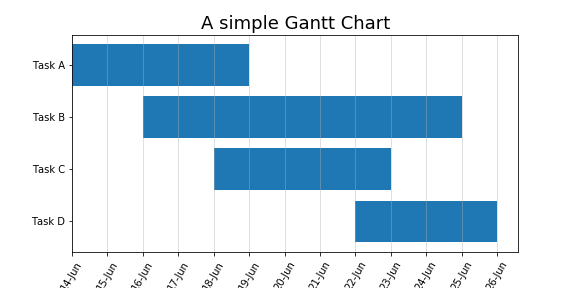

Image by author

Summary

Plotting a Gantt chart can be summarized in the following 6 steps:

Step 1: Read data Step 2: Convert dates to datetime format Step 3: Add Duration Step 4: Add relative date Step 5: Create custom x-ticks and x-tick labels Step 6: Create horizontal bar-graph with y=task, left=Duration and left=relative start date; invert y-axis

Resources

Resources for the article are available in my GitHub Repo.
