How to Create a Multi-Layer Gantt Chart Using Plotly
Create a Gantt Chart to Track Your Project Plan by Planned vs. Actual Completion Dates

A Gantt chart is a very popular and helpful visual for project managers and teams to plan and track project roadmap, schedules, and progress. A basic Gantt chart illustrates a project plan by listing the tasks to be performed on the vertical axis, and a timeline with planned start and finish dates for each task on the horizontal axis.

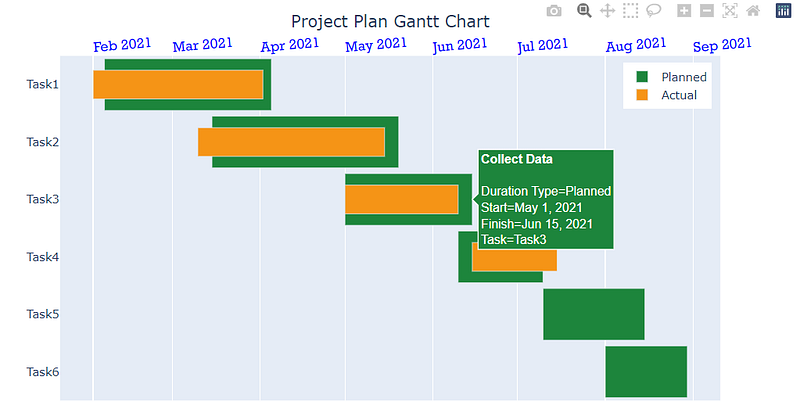

Sometimes in addition to showing the planned schedule for the tasks, we also want to show the actual start and completion dates for all the tasks. The Gantt chart below is a multi-layer Gantt chart that contains two layers for the planned and actual dates: the ‘planned schedule’ bars (green) are the first layer of the Gantt chart, and the ‘actual schedule’ bars (orange) are the second layer. How can we easily create a multi-layer Gantt chart like this using Python?

In this post, I’ll show you how to easily create a multi-layer Gantt chart using Plotly. For those of you who are not familiar with Plotly, the Plotly Python library is an interactive, open-source graphing library that covers a wide range of chart types and data visualization use cases. It has a wrapper called Plotly Express which is a higher-level interface to Plotly and is super easy and quick to use as a starting point for creating some of the most common visualizations.

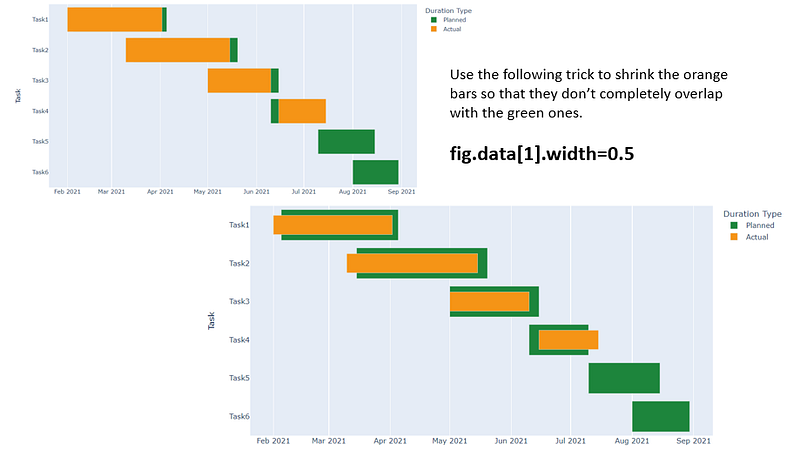

Plotly also has a lower-level graphing package called Plotly Graph Objectsthat generally requires a bit more coding but is more customizable and flexible compared to Plotly Express. In this post, we’ll use Plotly Express to plot the multi-layer Gantt chart.
If you don’t already have plotly on your computer, you can install it by running the following command:

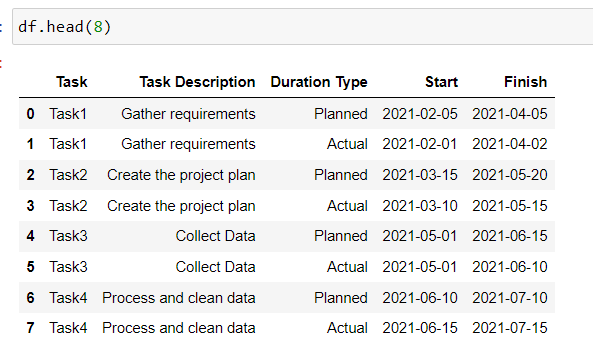

pip install plotlyLet’s first import all the libraries and read our sample data into a Pandas dataframe. Notice that the data is structured in a way that for each task we have two rows of data, one for the planned start and finish dates and the other for the actual start and finish dates.
